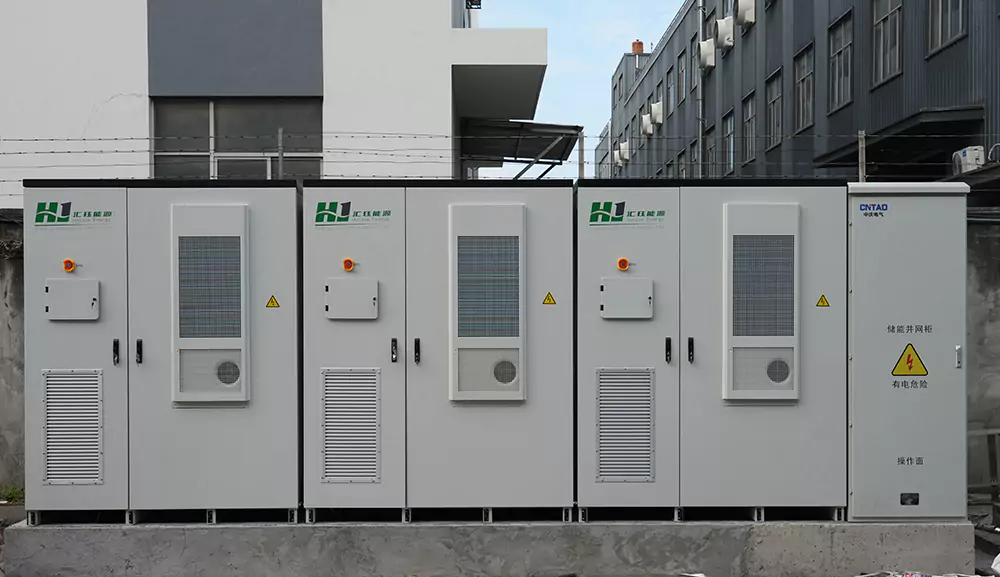

The project began in April, with construction starting in August and installation and commissioning completed by September. By October, the installation, commissioning, and acceptance of 13 energy storage cabinets at 5 locations were finished.
Each energy storage cabinet has a capacity of 215 kWh.
The project is distributed across 7 key locations in Taizhou, Zhejiang, with each location equipped with a 215 kWh energy storage cabinet. The project has successfully been implemented, with a total of 20 MWh successfully installed, offering a new energy solution for local industrial, commercial, and residential users.
- The project was launched in April 2024, with on-site solution design commencing.
- Construction began in August 2024.
- Installation and commissioning were completed by September 2024.
- By October 2024, installation and commissioning of 13 energy storage cabinets at 5 locations were completed, and the National Grid’s distributed power project was successfully grid-connected and passed inspection.
- By November 2024, all inspections were completed after 7 months.
Project Details
Application: User-side industrial and commercial energy storage, primarily used for industrial, commercial, and residential users. The system leverages peak-valley price arbitrage to reduce electricity costs.
Installed Capacity: 2795 kWh
Main Equipment: Energy storage cabinets, grid connection cabinets, energy storage inverters (PCS)
